Which of the following project planning situations is the most frequent contributor to cost overruns?

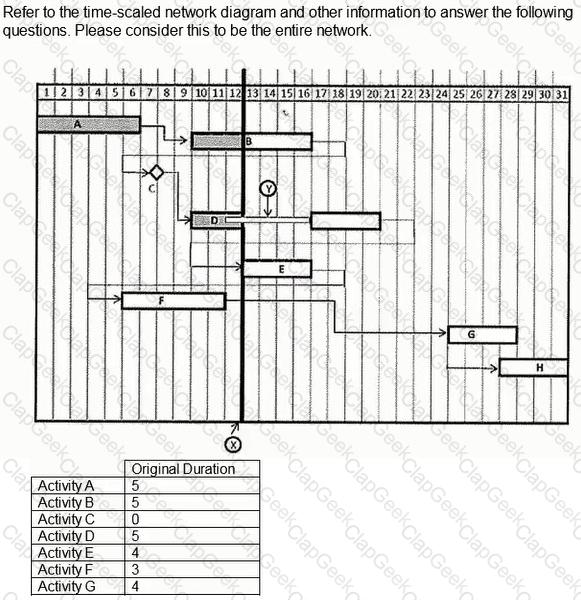

If Activity A was delayed 5 days from starting, which of the following adjustments will NOT maintain the completion date of Activity C at Day 40?
In order for a claimant to be entitled to an extension of contract time for a delay event (and further to be considered compensable):

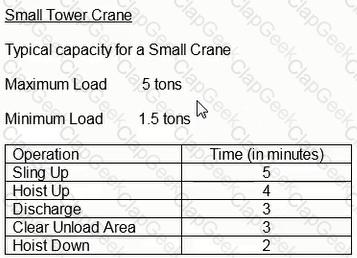

Assuming a total of 30 lifts per crane per day, what is the maximum number of lifts that could be accomplished using 3 small tower cranes over a 5-day period?
When should the project documents be reviewed to assess their impact on the organization and administration of a project?

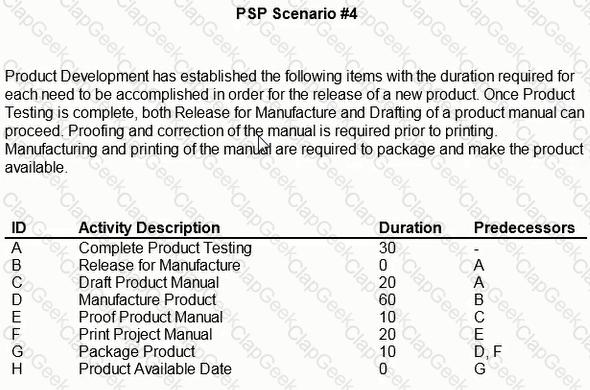

Scenario: You are providing construction management services for a small office building project. Your duties include reviewing and approving the contractor's baseline schedule. The contractor has submitted the first baseline schedule for the project.
The contractor has included several reports with its submittal, including a report that sorts all activities by total float. What is the value of this report?

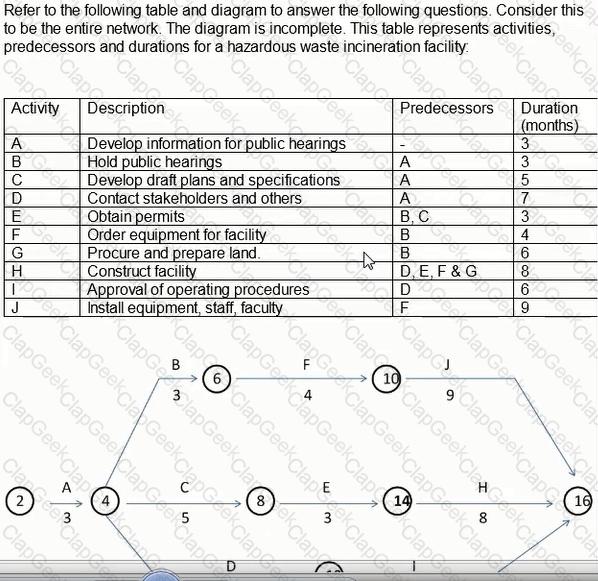

In the "normal" schedule, excluding Activity 1000, what activity(s) are concurrent with Activity 3001?
You are retained by a contractor who asks you to perform a simple as-planned versus as-built analysis (APAB) of a large hydro-electric dam project that took more than five years to complete. Your analysis will form the basis of a change order that requests a time extension. You suggest using a different methodology for quantifying the delay. Which of the following reasons for recommending a different analysis does NOT apply to a simple APAB analysis?
Which of the following is NOT a tool or technique used to perform scope planning?
Schedules are periodically updated to reflect progress. What step should NOT occur before the update is considered complete?

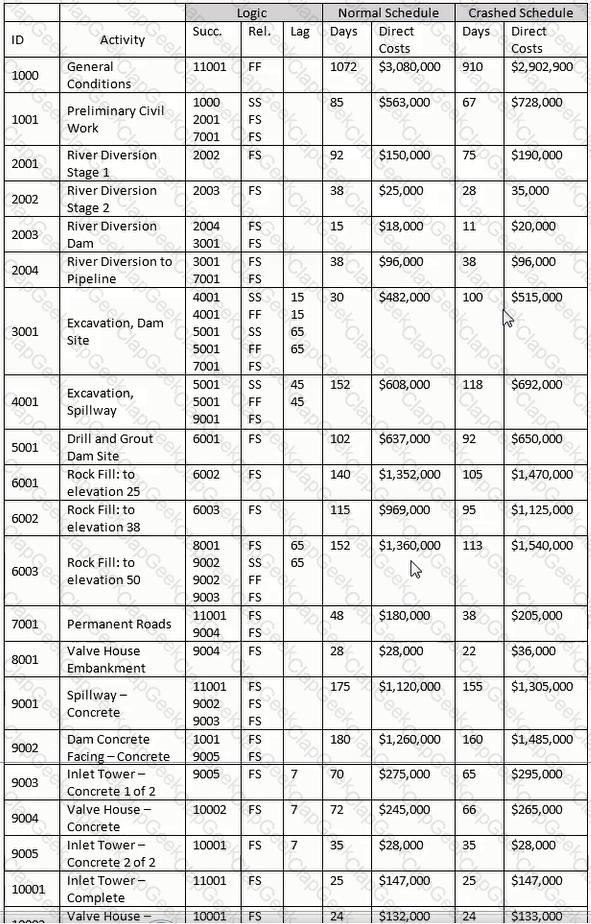

Using the normal schedule, theoretically construct a hammock for activities 6001-6003. What is the duration of the hammock?
For activity 11001. why would the crashed direct cost be greater than the direct cost of the normal schedule?

Before the work begins, the contractor considers crashing the schedule. How much would the crashed general conditions have to be reduced to break even with the normal cost budget?
Which of the following is least likely to affect the criticality of resources in resource planning process?
As the project plan is developed a mechanism is developed to communicate the projects organic structures that will facilitate reporting against the baseline schedule and cost estimate or budget Which of the following is NOT used for reporting?
Using the "normal" schedule, theoretically construct a hammock for activities 6001-6003. What is the duration of the hammock?
Prior to the beginning work on Activity 6001, the scope is changed by executed change order to increase the activity duration by thirty days and rock fill by 100.000 cubic meters If the project has progressed as scheduled up to the point of the executed change order, what activities would be changed on the next project update?
In its simplest form, what is the main drawback of critical path method scheduling?
Total float is defined as the amount of time an activity can be delayed without impacting
Which of the following options is NOT a feasible method to reduce the overall completion time of the toll road program?
The Organizational Breakdown Structure (OBS) is a hierarchical structure that does NOT include which of the following:
Using a 1.75 cubic yard [1.34 cubic meter] bucket, how many lifts does it take to pour each 2.000-cubic foot [56.64 cubic meter] column?
The characteristic of the precedence diagramming method that models construction projects differently than the arrow diagramming method is that it____________.
When using a detailed estimate as the basis for work package/activity durations, which element does NOT need to be identified before the activity durations can be calculated?
Scenario: You are providing construction management services for a small office building project. Your duties include reviewing and approving the contractor's baseline schedule. The contractor has submitted the first baseline schedule for the project.
The contractor's baseline schedule submittal includes a bar chart, but no CPM diagram. Which of the following is the most significant shortcoming to using a bar chart to review the baseline?
When a fragnet of activities represents a known schedule risk, which activity will most likely change the overall outcome?
In a graphical earned value analysis, what time-scaled value determines the reporting intervals for both schedule and cost performance?
Should you verify the as-built schedule before proceeding with a schedule analysis?
Assuming that you had only one crane capable of 30 lifts per day, 3 column pours requiring 28 lifts each, plus associated assorted work requiring an additional 150 lifts, what is the minimum planned working duration for this work?
Using the normal schedule, given Activity 3001 and the relationship with Activity 4001. what is indicated?
Which is NOT an industry-recognized methodology for quantifying critical delay?
Which of the following is NOT required when performing weekly or monthly schedule updates?
